Home Agriculture PAGSARMINGAN | The China-funded Banaoang Pump Irrigation System

PAGSARMINGAN | The China-funded Banaoang Pump Irrigation System

31
0
6 MIN READ
By SHERWIN DE VERA
www.nordis.net

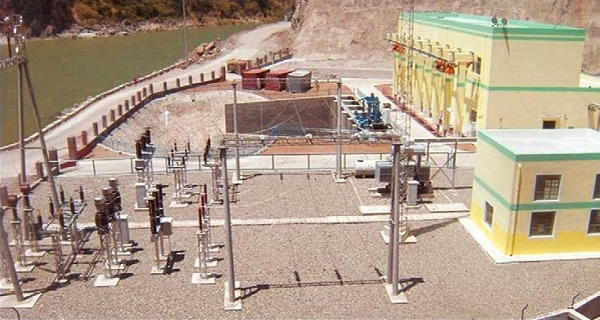

PUMPING STATION.The facility located 800 meters upstream of the Banaoang Bridge on the banks of the Abra River in Brgy. San Mariano, Bantay, is composed of 7 pumps and motors. Water is delivered through its 20-kilometer irrigation main canal (including the 1376.6-meter tunnel) and eight lateral channels. Photo from China CAMC Engineering Co., Ltd. website.

BAGUIO CITY — Questions on the provisions of the loan agreement between the Philippines and China regarding the Chico River Pump Irrigation Project (CRPIP) are snowballing. People in Congress, Supreme Court, and down to the grassroots are expressing their different concerns. Netizens are posting memes depicting sell-out of Philippine sovereignty and sharing news on China’s debt-trap diplomacy to other countries.

Understandably, reports on the issue focused on the constitutionality and content of the contract governing the loan with the continuing tension in the West Philippine Sea, influx of Chinese workers in the country, and the Supreme Court petition challenging the loan agreement.

But an equally important consideration is the issues plaguing the irrigation systems in the country such as high-cost overruns, bloated projections of serviceable area, technical shortcomings, and corruption. Concerns that manifested in an existing and operating structure funded and built by the Chinese government.

Before the controversial CRPIP in Kalinga, the National Irrigation Administration (NIA) undertook the Banaoang Pump Irrigation Project (now Banaoang Pump Irrigation System or BPIS) in Ilocos Sur.

There are stark similarities between the two projects. First, BPIS was the Arroyo government’s showcase in its Comprehensive and Integrated Infrastructure Program. The CRPIP, on the other hand, is a flagship project of Duterte’s “Build, Build. Build” program. Second, both projects are part of the Rice Sufficiency Program, which targets to boost the country’s rice production. Lastly, both are heavily dependent on Chinese credits for construction.

The Chinese connection

The loan extended by the Chinese government for the CRPIP covers about 85% of the P4.37 billion project cost compared to the 90% project coverage of the credit for the BPIS. In both projects, the lender chose the company to build the structure. China CAMC Engineering Co., Ltd. (CAMCE) for the former and the China National Construction and Agricultural Machinery Import-Export Corporation (CAMC) for the latter.

According to NIA, China provided P1.3 billion (($35 million during the period) of the P1.53 billion facility. It was designed to provide irrigation for eight local governments: Bantay, Sta. Catalina, San Ildefonso, Caoayan, Magsingal, Sto. Domingo, San Vicente, and Vigan City in Ilocos Sur. Irrigation service will cover 6,312 hectares of agricultural land with 5,334 farm household beneficiaries.

Funding for the facility was part of $100 million credit for agriculture development secured by the Arroyo government during a state visit. The Department of Finance and China National Construction and Agricultural Machinery Import-Export Corporation (CAMC) signed the formal agreement with a 3% interest payable within ten years, including the 2-year grace period. Also included in the deal was to utilized part of the amount to purchase equipment for the project. Payment for the loan was supposed to end in June 2008 but extended until December 2009.

In an interview with Engineer Rex Utrera, acting unit head for operations of NIA Ilocos Sur, he recalled that Chinese engineers and supervisors were overseeing the entire construction. But he does not know if taking Chinese workers and the identification of the construction company was part of the loan agreement.

Also, a logistics company, CAMCE Logistics Co. Ltd., claimed that it provided the “large number of pipes, pumping stations, concrete mixers, concrete materials, and other project materials” and arranged for the transport of the items during the construction.

CAMC and CAMCE Logistic are both associated with China CAMC Engineering Co., Ltd., (CAMCE) the company assigned to build the CRPIP. On their website, CAMC declared that it is a “wholly-owned subsidiary” and the other a “company held” by CAMCE.

Snags along the way

Construction started in March 2003, with project completion seen within three years. NIA in June last year announced that CRPIP would take the same time to finish. In 2005, NIA reported the construction of was in full swing and announced a slight increase in the project cost by about P400 million.

By 2007, construction activities slowed down while NIA asked for a P1.24 billion additional budget for the project. In the same year, the National Economic and Development Authority (NEDA) reported that the BPIP incurred the highest cost-overrun despite far from being finished.

There was no mention in the NEDA document of the reasons for the increase from the original budget. However, the Philippine Center for Investigative Journalism cited in its article that “currency exchange rate movement, modification in the scope of works, and increase in right of way acquisition cost” is the reason for the project budget adjustment.

The Investment Coordination Committee (ICC) during its December 13, 2007 meeting requested NIA-DA “to seek first the DBM advice on the procedural lapse and ensure that all necessary legal action will be taken towards the resolutions of said issue.” But until April 30 the following year, no update was provided by the concerned agencies.

Then-President Gloria Arroyo visited the site in January 2010 with NIA chief Carlos Salazar and ordered its immediate completion. In the event, the NIA official said the facility is already 87% complete. He even boasted that it was already supplying water for more than a thousand hectares. The official also promised to finish the facility by April of the year.

Despite the order of Arroyo and promise made by Salazar, the project dragged on for another year. The BPIS was finally turned-over and inaugurated for operation in July 2011, benefiting 4,220 families and covering 5,232 hectares. Its total cost reached P2.5 billion, about 92% higher than the P1.3 billion approved by the NEDA.

“Completed” with continuing issues

In 2015, the NIA website reported the project as “complete.” However, an interview with NIA officials during the same period revealed the project was far from being finished. They admitted that they are yet to complete and repair construction flaws in some sections of the project. In the same year, P40 million was allotted to continue the facility and to resolve the design deficiencies.

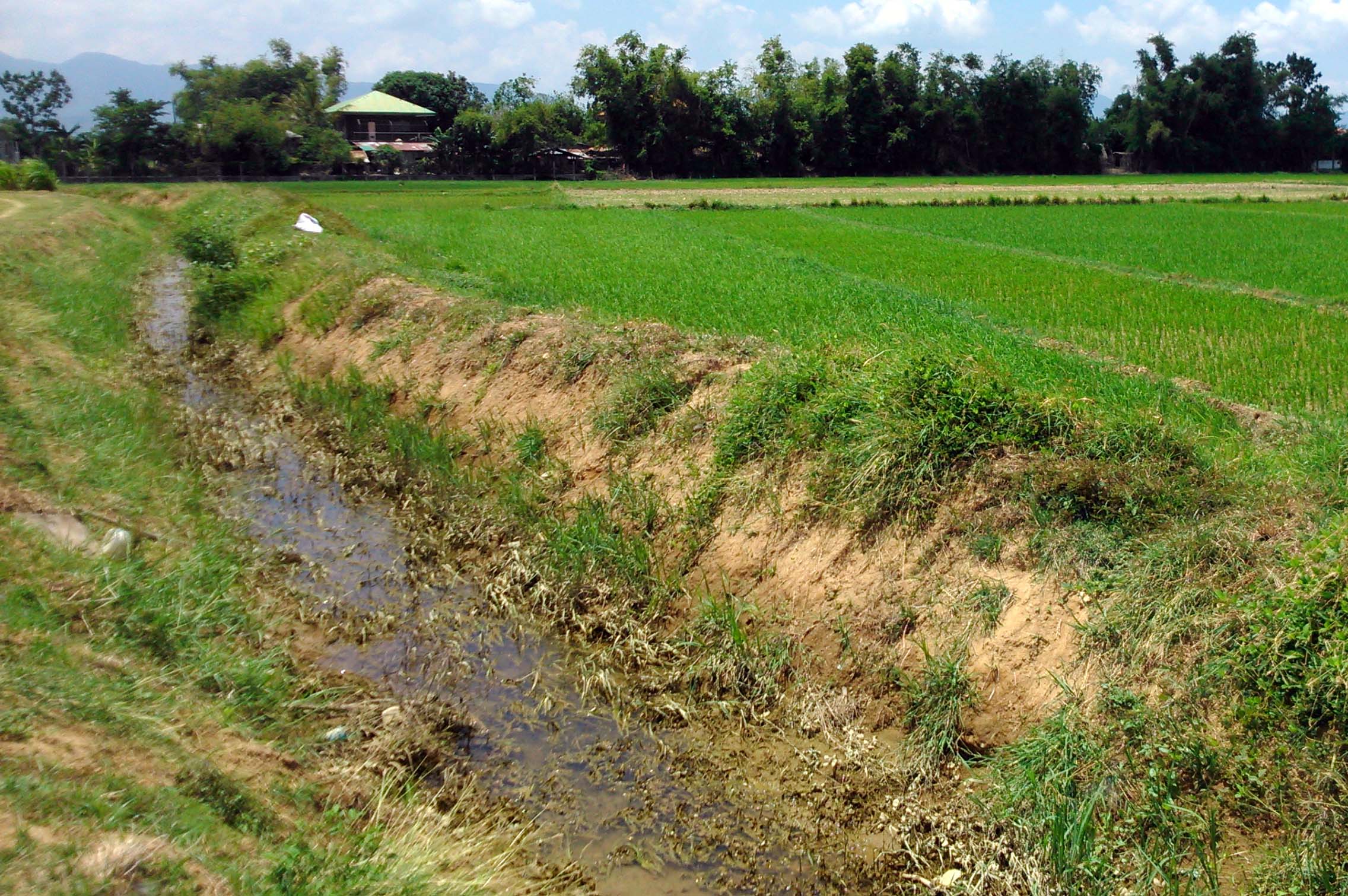

INCOMPLETE. File photo taken in June 2015 shows an unlined section of the BPIS Main Canal in Cabalangan, Bantay.Photo by Sherwin De Vera

Of the service area declared during the inauguration, only 1,873 hectares were firmed-up for irrigation, of which 855 hectares were operational.

Also, a 2016 study conducted by researchers from the Philippine Institute for Development Studies (PIDS) identified technical issues in the construction and operation of BPIS. The findings cited siltation, canal-related problems, the high operation cost of the pump, and difficulties with the machines and equipment.

According to Utrera, parts of the Main Canal and Lateral Canal D are the only lined (cemented) portions of the irrigation when the contractor turned over the project for operation. He said the paving of most of the eight lateral canals was relatively recent. They have also resolved the majority of the construction defects, such as wrongly positioned turnouts and gates, along with inappropriate canal elevations.

These steps increased the service area to 1,150 hectares but still short of 4,082 hectares from the reported service area by DA when it was turned-over to NIA Ilocos Sur. To date, all local governments targeted for the service are using the facility except for Sta. Catalina, who opted for exclusion from the project, said the NIA official.

The acting operations head explained the refusal of farmers to give up part of their land for the canals and service roads is among the reasons they failed to realize the designed area. Sta. Catalina in particular, he said, preferred planting high-value crops that do not demand much water, cultivating rice only during the rainy season.

He said many were reluctant to use the irrigation due to the prohibitive cost when the facility started operating. Before the passage of the Free Irrigation Law in 2018, the BPIS fee was P5,600/hectare on the wet season and P7,500/hectare during the dry season.

A tale told twice

The BPIS provides an added and solid ground to be concerned about the CRPIP loan agreement.

First, it involves subsidiary companies of the Chinese builder tasked to build CRPIP with a record of delayed project completion and construction flaws. Issues that will cost tax-payers millions of funds if left unchecked in the course of the construction.

Second, the failure of the contractor to work on the original budget and the massive gap between the designed and actual service area are red flags for possible corruption and a flawed design.

Third, the conscious effort of government officials to provide false figures and half-truths in this China-funded and built project make circumspection imperative for all aspects of CRPIP.

Fourth, the lack of consultation with the affected farmers is apparent with one of the underlying reasons shared by Utrera that caused a considerable difference in the service area. This experience points to the need for thorough and strict conduct of the Free, Prior, and Informed Consent as a critical concern for CRPIP, which is within the ancestral domains of indigenous peoples.

Lastly, it highlights the fundamental issue of genuine land reform, with most farmers refusing the project due to limited land and meager capital to afford irrigation service.

With a dynastic landlord ruling the town with the largest serviceable area of CRPIP, the more pressing matter is to identify who would greatly benefit from the facility. # nordis.net

*Pagsarmingan is the  Ilokano of the phrase “something to reflect on”.
